You are inspired to make your fortune by starting a distance learning enterprise to teach the world Computer Science, using multimedia lessons distributed over the Web.
Write notes for a business plan for the potential investors, under the following headings [ 5 marks per heading]:
(a) The Market [5 marks]
(b) The team required [5 marks]
(c) Outline overall project plan [5 marks]
(d) Business model, with a rough estimation of capital expenditure and profitability[5 marks]
Solution notes:
(a) The market
The market is
However this is a market where severe competition can be expected, with few barriers to entry. The education industry has some trusted brands, such as Cambridge and Stanford. Use of such a brand, (e.g. "The Cambridge Studies in Computer Science"), if possible, would ease market entry and raise barriers to competition. Therefore an early goal would be to seek alliance with a prestige brand.
(b) Team
CEO (and PA)
CFO (may be the same as CEO)
CTO: web designers and programmers (4?); Educators (4); help desk and
support staff(4)
V.P. Marketing ; Sales staff (4)
Say 20 people.
(c) Outline plan

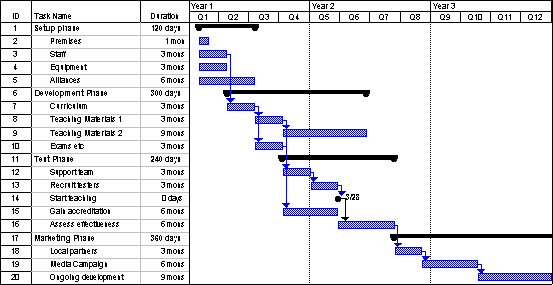

We draw a GANTT chart:
(N.B. More concerned with the thought processes and principle, than the detailed estimates)

(d) Business model
The primary business model is to sell subscriptions to the course, similar to, say, the Open University model. Additional income sources may be from advertising on the web site, book and other adjunct sales, and from arrangement of additional local teaching.
Assume (per annum of full production):
100K students, £100 net subscription, thus £10M subscription revenue
Advertising: say £10 pcm on 10M page hits £1M
Additional income, commissions etc £1M
Total revenue £12M
Say 20 permanent staff at £100K each including overheads £2M
Variable costs: external exam fees, materials etc per student: £30: £3M
Marketing spend £3M
Total expenditure: £8M
Gross Profit: £4M p.a.
This assumes that one-on-one tutorials are self-funded by separate fees, otherwise the expenditure is dominated by these costs.
Capital Expenditure estimate
Computers etc: £2M
2 years permanent staff operating expenses before return: £4M
1 year marketing £3M
Capital expenditure of £9M;
This indicates about a 45% return. Possible, but not wonderful compared to a venture capital target of 60% IRR. Consideration should be given to reducing the initial marketing spend, for example.
Also no contingency has been allowed for.
Obviously, more research, a much more detailed model, with justification for the numbers, detailed cash flow and sensitivity analysis would be essential before contemplating such a business.
